D-4.2 Testing Methods

Safety is of paramount importance when conducting leak tests. Even at relatively low internal pressures, leak testing can generate very high forces that can be dangerous if suddenly released by the failure of a joint, system component, or testing component. Air testing is inherently more dangerous than water testing, since air is highly compressible and expands quickly when pressure is released. If high air pressure is used, this expansion can be violent.

Always take safety precautions, such as the following, when conducting leak tests:

  • Install all test plugs in a manner that prevents blowouts. Restrain pipe, components, and test equipment from moving in the event of a failure.
  • Ensure that all air pressurizing equipment used for testing includes a regulator or relief valve set no higher than 63 kPa (9 psi) to avoid over-pressurizing.
  • Keep people not involved in testing a safe distance away while testing.
  • General safety instructions for inflatable test plug usage:
    • Read and understand the safety instruction sheet before using a test plug.
    • Always wear PPE.
    • Do not enter the safety zone when test plugs are under pressure.
    • Measure the pipe diameter accurately before selecting a test plug.
    • Never use a test plug in a pipe size different from the recommended usage range.
    • Always inflate the test plug to the recommended pressure shown on the plug.

Test Equipment

Different test equipment will be required depending on the type of DWV test that will be performed.

Test Plugs

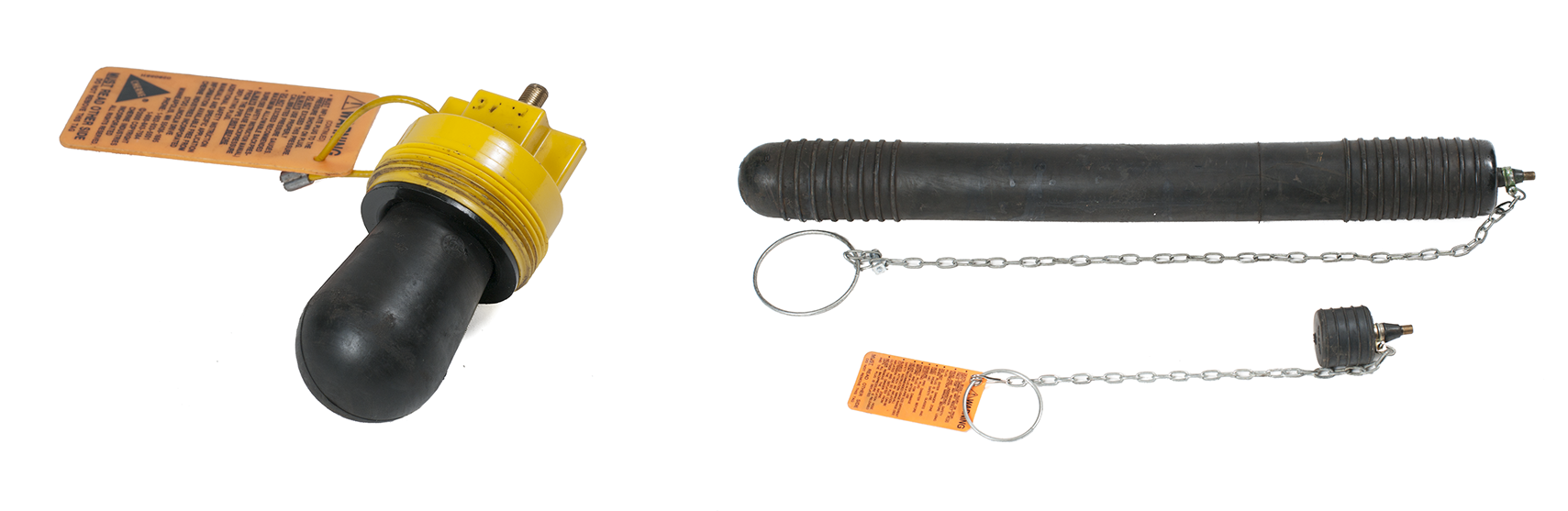

Whether the test is by water, air, or smoke, all openings in the test section must be sealed. Test plugs are often used in the industry because they may be used repeatedly and are, therefore, cheaper than one-time-only test caps. Test plugs are available in a number of configurations, such as inflatable for use in a line cleanout or inflatable for use in a wye fitting (Figure 1).



"Image showing two inflatable test plugs: one on the left for use in a line cleanout and one on the right for use in a wye cleanout, both with attached warning tags."
Figure 1 Left: Inflatable test plug for use in a line cleanout; Right: Inflatable test plug for use in wye cleanouts. (Skilled Trades BC, 2021) Used with permission.

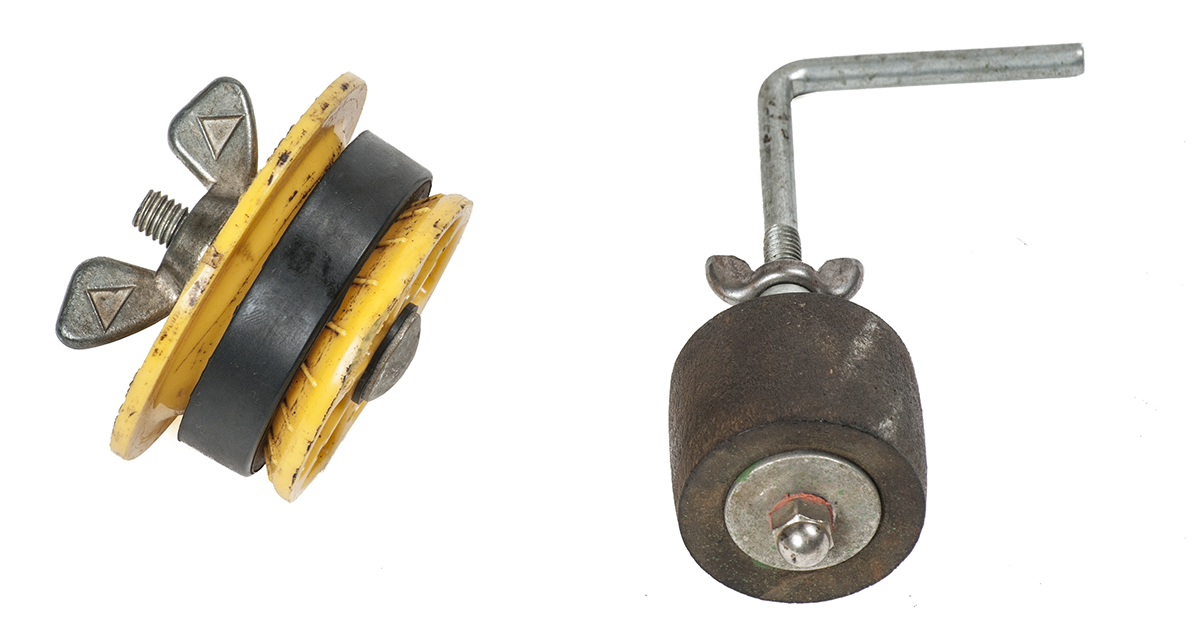

When sealing open pipe and fitting hubs for testing, you may use an expansion plug. These devices are not inflatable but use the expansion of a rubber sleeve to provide a seal. The expansion plug is inserted in the opening and tightened by hand or a smooth-faced wrench (Figure 2).



"Image of two hand-tightened expansion-type test plugs, featuring adjustable wing nuts and rubber sealing components."
Figure 2 Hand-tightened expansion-type test plug. (Skilled Trades BC, 2021) Used with permission.

Water Pressure Tester

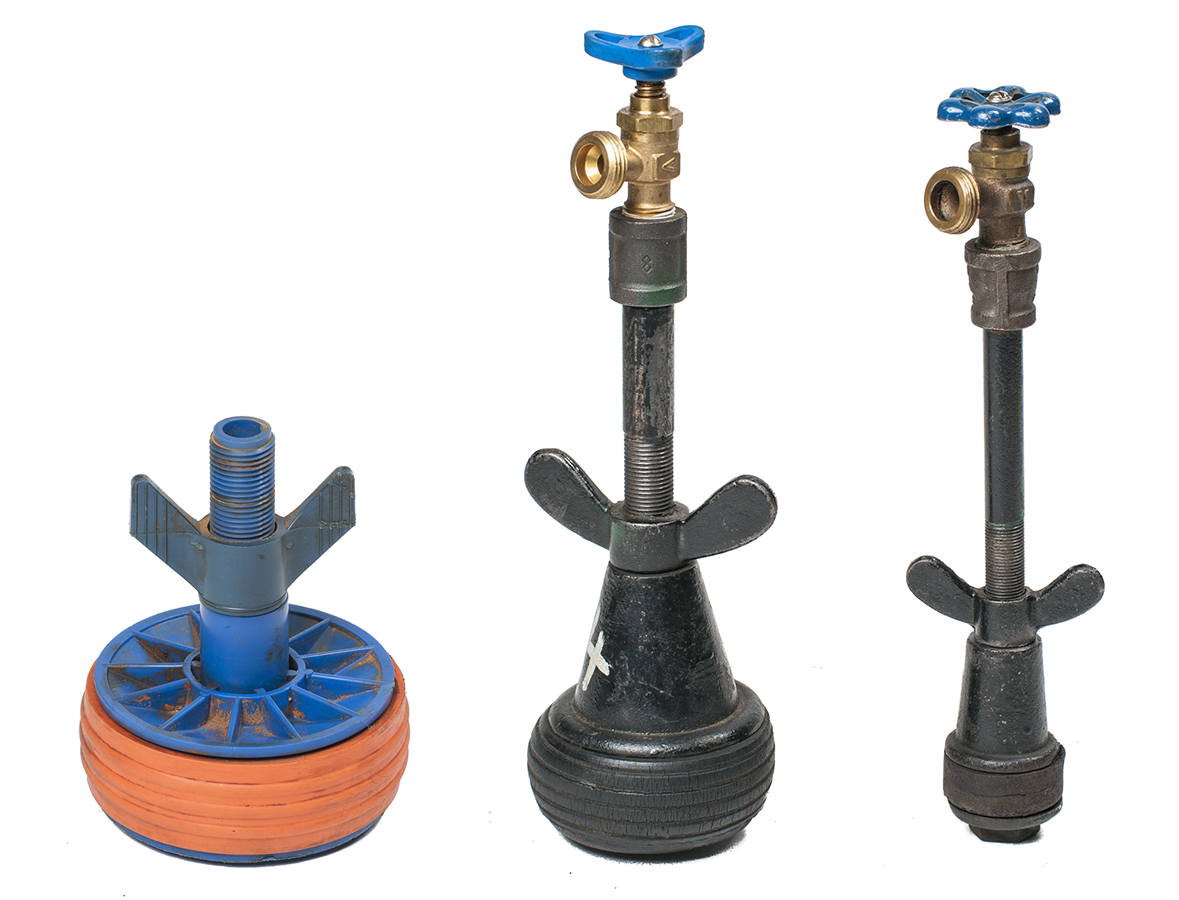

A water pressure tester allows you to introduce and measure the water pressure in a plumbing system. Used in conjunction with open centre test plugs, it allows access to the DWV system without cutting lines or creating leaky threaded joints (Figure 3).



"Image of three open center test plugs, each featuring a valve at the top and designed with a central opening for pressure testing purposes."
Figure 3 Open centre test plug. (Skilled Trades BC, 2021) Used with permission.

Air Pressure Test Equipment

Another acceptable method for testing drainage and venting is an air pressure test. This is recommended if testing must be done in sub-zero temperatures or over water-sensitive areas, such as computer labs, hospital operating theatres, and rooms containing archives. Although these situations are rare to most installers, air tests have been employed when testing DWV systems in similar environments. As with a water test, the entire system or section you are testing must be completely sealed with airtight test plugs. The air pressure may be introduced into the system with a compressor, provided that a properly calibrated regulator is installed.

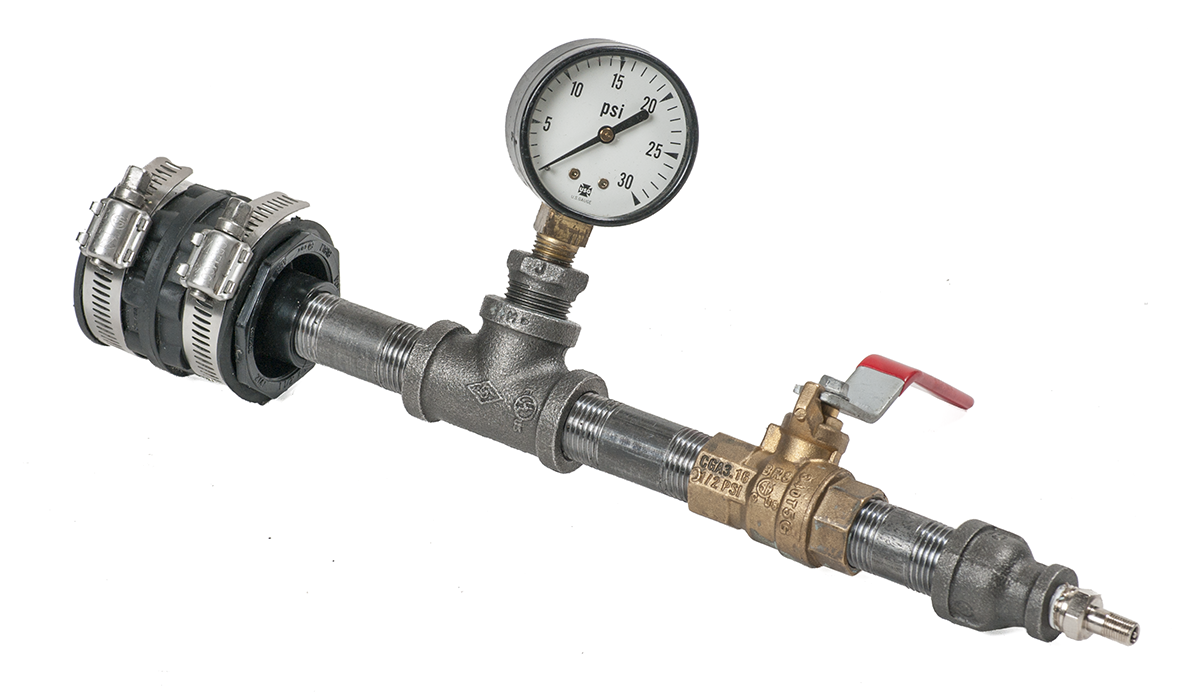

The air pressure may be introduced and recorded through a pressure gauge and Schrader valve combination (Figure 4).

A shop-built pressure testing assembly can be added to the drainage system. Pressure is applied through the Schrader valve, then the ball valve is closed. The system should hold pressure for 15 minutes at 5 psig when tested.



"Image of a pressure testing assembly for DWV (drain, waste, vent) pipe, featuring a pressure gauge, valve, and pipe clamps."
Figure 4 Pressure testing assembly for DWV pipe. (Skilled Trades BC, 2021) Used with permission.

Smoke Test Equipment

Smoke testing requires the use of a blower and a controlled smoke source.

Blowers

The NPC requirements for smoke testing identify a static pressure of a 25 mm (1 in.) water column. This requires the use of a blower capable of producing the test pressure. Two types of blowers are available for smoke testing DWV systems:

  • Squirrel cage
  • Direct-drive propeller

Squirrel-cage blowers are generally larger and can provide more static pressure in relation to CFM output. The output of the squirrel-cage type is usually adjustable by alternating pulleys and belts to meet the demands of the job.

Propeller-style blowers are usually more compact, and the output is not adjustable since the fan blade is attached directly to the engine shaft.

Smoke Sources

Two types of smoke sources are currently offered for smoke testing DWV systems:

  • Smoke candles
  • Smoke fluids

To use a smoke candle, simply place one on the fresh air intake side of the blower. Once the candle has been ignited, the exiting smoke is drawn in with the fresh air and blown down into the system. This type of smoke is formed by a chemical reaction and has a high atmospheric moisture content. It is very visible even at low concentrations and extremely effective at finding leaks.

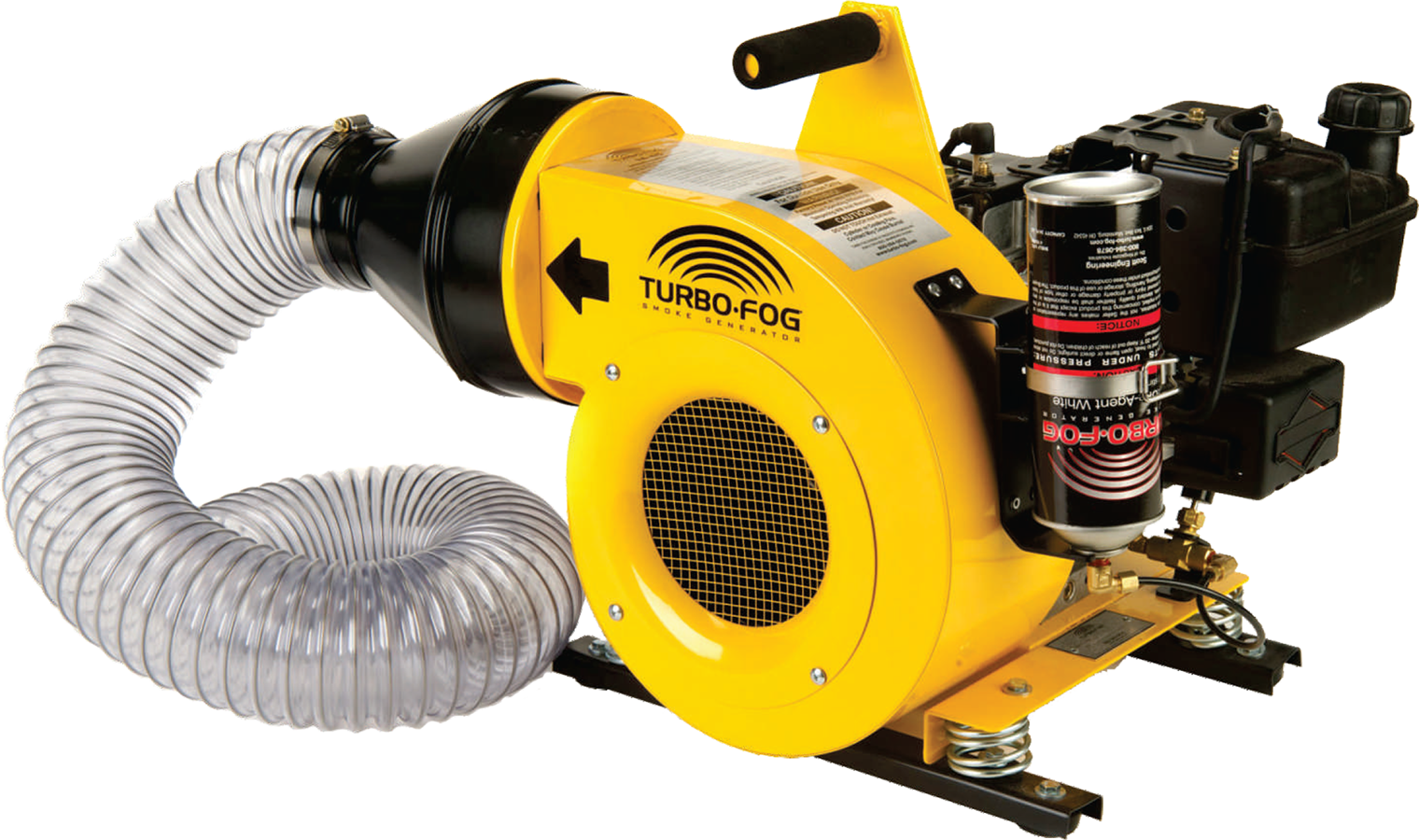

A smoke fluid system involves injecting a smoke fluid (usually a petroleum-based product) into a heating chamber, such as the engine exhaust muffler of a portable blower engine (Figure 5). The smoke is then exhausted into the fresh air intake side of the blower. Smoke fluids do not consistently provide the same quality of smoke because as fluid is injected into the heating chamber, it immediately begins to cool the heating surface. The heating chamber will eventually reach a point where it is not hot enough to completely convert all the fluid to smoke, and it will then produce thin, wet smoke that is difficult to see. This can happen quickly, depending on the rate of fluid flow. Some manufacturers have taken steps to address this issue and now offer insulated heating chambers to help maintain necessary temperatures.



"Image of a smoke testing machine for DWV pipe, labeled 'Turbo-Fog,' using liquefied smoke and featuring a flexible hose for testing."
Figure 5 Smoke testing machine for DWV pipe using liquefied smoke. (Kingscote Chemicals, n.d.). Used with permission.

DWV Test Procedures

Test procedures vary with the type of test needed for the installation.

Water Test

A water or hydrostatic test is the most common test used to inspect a DWV installation. This is the recommended test in most plumbing codes, weather permitting. Before starting the test, all bends, changes of direction, and ends of runs should be properly restrained. Cap or plug all openings in the lower part of the section to be tested. Fill the system to be tested with water at the highest point, if available. If this is not possible due to job-site conditions, use an open centre test plug.

Filling the system slowly should allow any air in the system to escape as the water rises in the vertical pipe. All air entrapped in the system should be expelled prior to beginning the test. Failure to remove entrapped air may give faulty test results. Once the piping has been filled to 3 m (10 ft) of head, the section being tested should be visually inspected for leaks. If leaks are found, drain the system, disassemble the joints, and check for proper installation. Once you have successfully tested the system, drain it and prepare the next section for testing.

In single-family houses, an adapter with a hose bib is commonly attached to a trap arm. Water is fed through a hose connected to the bibb, and the system is filled until water spills from the roof vent. This method eliminates the need to get a hose into the open vent on the roof, which would have created issues with fall arrest procedures.

Air Test

Prior to performing the air test, all threaded openings shall be sealed with a manufacturer’s recommended sealant. All additional openings should be sealed using test plugs recommended for use in performing air testing. It is important to note that manufacturers of cast-iron soil pipe and fittings joined with rubber compression joints or MJ couplings expect to have a reduction in air pressure during a 15-minute test. This drop in air pressure does not indicate a failure of the system or that the system will leak water. The reduction occurs because air molecules are much smaller than water molecules and can escape through microscopic perforations in the pipe wall formed during the casting process.

However, a reduction of more than 7 kPa (1 psi) during the test period indicates a failure of the test. The system shall be pressurized to 35 kPa (5 psig) using a gauge graduated preferably to not more than three times the test pressure. Upon completion of the test, depressurize the system and remove the test plugs.

Smoke Test

When a system has been completely installed with some sections obscured from view, a smoke test may be required by engineers, architects, or plumbing codes to find leaks in the piping. The test is applied to all the parts of the drainage and venting system after all fixtures have been permanently connected and all traps have been filled with water. A thick, penetrating smoke produced by one or more smoke machines is introduced into the bottom of the system through a suitable opening. As the smoke appears at the stack opening on the roof, the opening is closed off and the introduction of smoke is continued until a pressure equal to 25 mm (1 in.) of water is built up and maintained for 15 minutes without the addition of more smoke. Under this pressure, smoke should not be visible at any point, connection, or fixture. To eliminate drafts, all windows in the building should be closed until the test has been completed.

Ball Test

A ball test does not check for leaks but instead ensures the drainage pipes have a proper grade. The local plumbing inspector may exercise discretion and insert a ball into a fitting to check for an adequate grade; if all is well, the ball will make it to the bottom point, which is normally a cleanout.

Duration

A DWV system undergoing pressure testing using an approved method and procedure shall withstand the test pressure for 15 minutes while the plumbing inspector is present.

Inspection

Upon completion of the roughed-in piping installation, the piping of plumbing drainage and venting systems shall be tested by water or air to prove it is watertight. The inspector’s job is to make sure that the testing of the DWV system follows the plumbing code requirements. The inspector may require the removal of any cleanout plugs to determine if the pressure has reached all parts of the system.

During the construction of any project, large or small, the DWV test will be witnessed and signed off by the AHJ upon satisfactory completion of each phase. The plumbing contractor should record and maintain detailed inspection and testing data showing the date, time, and names of people participating in the inspection and testing.

Documentation

It is safe to say that the DWV system is an important part of the building design and function, which is why the final plumbing installation must be inspected before calling for the final building inspection. Once the plumbing and other individual disciplines have substantially completed their work, a certificate of occupancy may be issued.

A certificate of occupancy is a document issued by a local government agency or building department certifying a building’s compliance with applicable building codes and other laws and indicating that it is in a condition suitable for occupancy. The procedure and requirements for the certificate vary widely from jurisdiction to jurisdiction and with the type of structure. Some projects may require certification from the installer that the plumbing system functions according to the approved design.
